Table 3 . Summary of outcomes reported to date for the activities in the LDC Project . Notes : 1 Includes projects from 2018 to 2021 although no completions reported in 2018 . 2 Calculated using the 2019 Alluvium model for the GBR Foundation Reef Trust Partnership ( Alluvium , 2019 ) for hillslope and streambank erosion and the Reef Trust Gully Toolbox for gully erosion . 3 Calculated using LDC Cost Effectiveness Tool described in Section 4.2.1 and 5.2 ; 4 Categorised into 3 classes for comparison : <$ 25 / t ; $ 25- $ 50 / t and >$ 50 / t . 5 GLM WW is Grazing land management Wire & Water . * Note that some projects have been removed from the cost effectiveness analysis as they were considered outliers or incorrect ( as discussed in the results above ).

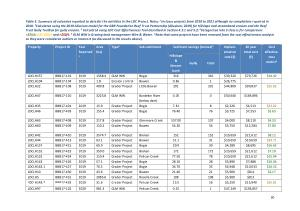

Property |
Project ID |
Year |
|
|
Reported |
1
Area ( ha )
Type 5
|
Sub catchment |
Sediment savings ( tonnes ) 2
Hillslope
|
Implementation cost ($) |
|
&
Streambank
|
Gully |
Total |
|
|
|
20 year total cost ($)
Cost effectiveness metric 3
LDCLH157 BBB17-101 2019 1568.4 GLM WW Bogie 316 316 $ 39,320 $ 79,726 $ 14.42 LDCLH104 BBB17-104 2019 1.8 Erosion control Bowen 0.86 1 $ 26,775 LDCLH22 BBB17-108 2019 409.8 Grader Project Little Bowen 201 201 $ 44,800 $ 90,837 $ 25.82
LDCLH47 |
BBB17-110 |
2019 |
3223.8 |
GLM WW |
Burdekin River |
|
|
|
|
|
( below dam ) |
0.00 0 $ 50,640 $ 149,894
LDCLH35 BBB17-401 2019 15.9 Grader Project Bogie 7.81 8 $ 2,226 $ 4,513 $ 33.02 LDCLH46 BBB17-403 2019 155.4 Grader Project Bogie 76.40 76 $ 3,725 $ 7,553 $ 5.65
LDCLH63 BBB17-408 2019 217.8 Grader Project Glenmore Creek 107.00 107 $ 4,000 $ 8,110 $ 4.33 LDCLH60 BBB17-409 2019 110.2 Grader Project Bowen 54.20 54 $ 3,750 $ 12,284 $ 7.80
LDCLH42 BBB17-410 2019 3574.7 Grader Project Broken 152 152 $ 10,659 $ 21,612 $ 8.12 LDCLH44 BBB17-413 2019 63.1 Grader Project Bowen 31.1 31 $ 10,659 $ 10,659 $ 39.71 LDCLH157 BBB17-415 2019 60.9 Grader Project Bogie 29.9 30 $ 4,289 $ 8,695 $ 16.62 LDCLH152 BBB17-423 2019 350.0 Grader Project Broken 172 172 $ 10,659 $ 21,612 $ 7.18 LDCLH132 BBB17-424 2019 110.4 Grader Project Pelican Creek 77.50 78 $ 10,659 $ 21,612 $ 15.94 LDCLH143 BBB17-426 2019 57.1 Grader Project Bogie 28.10 28 $ 3,890 $ 7,888 $ 16.04 LDCLH143.1 BBB17-427 2019 70.5 Grader Project Bogie 34.70 35 $ 4,948 $ 10,033 $ 16.52 LDCLH10 BBB17-430 2019 43.6 Grader Project Bowen 21.40 21 $ 5,900 $ 811 $ 2.17 LDCLH5 BBB17-431 2019 2085.6 Grader Project Rosella Creek 108 108 $ 5,900 $ 811 LDCLH143.2 BBB17-433 2019 31.6 Grader Project Pelican Creek 15.5 16 $ 5,250 $ 15,940 $ 35.81
LDCLH97 BBB17-102 2020 981.3 GLM WW Pelican Creek 0.65 1 $ 47,249 $ 139,857
30
