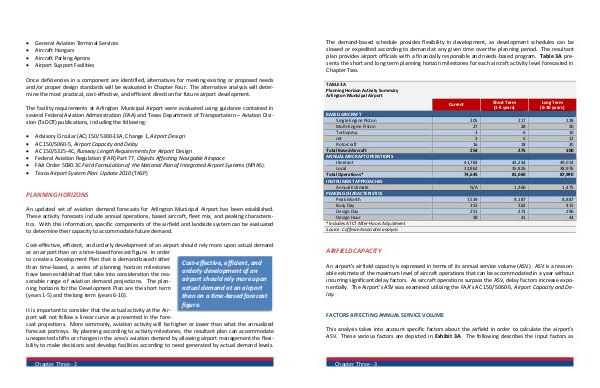

Arlington Municipal Airport Development Plan Arlington Airport Development Plan | Page 95
The demand-based schedule provides flexibility in development, as development schedules can be
slowed or expedited according to demand at any given time over the planning period. The resultant
plan provides airport officials with a financially responsible and needs-based program. Table 3A pre-
sents the short and long term planning horizon milestones for each aircraft activity level forecasted in
Chapter Two.
TABLE 3A
Planning Horizon Activity Summary
Arlington Municipal Airport
Short Term
(1-5 years)
Current
BASED AIRCRAFT
Single Engine Piston
Multi-Engine Piston
Turboprop
Jet
Rotorcraft
Total Based Aircraft
ANNUAL AIRCRAFT OPERATIONS
Itinerant
Local
Total Operations*
INSTRUMENT APPROACHES
Annual Estimate
PEAKING CHARACTERISTICS
Peak Month
Busy Day
Design Day
Design Hour
*Includes ATCT After-Hours Adjustment
Source: Coffman Associates analysis
Long Term
(6-10 years)
205
27
3
3
16
254 217
28
6
6
18
275 228
30
10
12
20
300
41,783
32,862
74,645 45,234
35,826
81,060 49,014
38,976
87,990
N/A 1,360 1,475
7,539
352
251
38 8,187
382
273
41 8,887
415
296
44
AIRFIELD CAPACITY
An airport’s airfield capacity is expressed in terms of its annual service volume (ASV). ASV is a reason-
able estimate of the maximum level of aircraft operations that can be accommodated in a year without
incurring significant delay factors. As aircraft operations surpass the ASV, delay factors increase expo-
nentially. The Airport’s ASV was examined utilizing the FAA’s AC 150/5060-5, Airport Capacity and De-
lay.
FACTORS AFFECTING ANNUAL SERVICE VOLUME
This analysis takes into account specific factors about the airfield in order to calculate the airport’s
ASV. These various factors are depicted in Exhibit 3A. The following describes the input factors as
Chapter Three - 3
